How to Value Engineer Aluminum Windows Without Sacrificing Performance

Direct answer

Builders can lower aluminum window costs without cutting performance by reducing unnecessary variation—not by weakening the product. Standardize similar sizes, limit glass makeups and finishes, use fixed panels where operation is not required, and plan packaging and delivery early. Keep the project’s energy, structural, water, safety and code requirements unchanged.

Good value engineering is not “make everything cheaper.” It is finding parts of the window package that add cost without adding useful performance.

On custom aluminum window projects, that cost often comes from too many one-off sizes, several nearly identical glass specifications, custom colors in small quantities, mixed hardware and late changes to the window schedule.

The best time to review those items is after the project requirements are clear but before shop drawings and production are released.

Custom aluminum windows for a residential building project

Start by Locking the Requirements That Cannot Move

Before asking an aluminum window manufacturer to reduce cost, identify the items that are fixed by the drawings, energy report, structural criteria or code.

Energy performance

Keep the required whole-window U-Factor and SHGC. Changing the frame or glass is only useful if the revised configuration still meets the project target.

Structural and water performance

Design pressure, tested size, water resistance and air leakage requirements should not be reduced simply to reach a lower price.

Safety glass and egress

Tempered or laminated glass locations, emergency escape openings and required ventilation must stay in the scope.

Installation conditions

Nail fins, brackets, subframes, flashing transitions and wall depth need to match the actual building assembly.

Required operation

A bedroom egress window, bathroom vent or accessible opening cannot be changed to fixed glass just because fixed windows cost less.


Where Aluminum Window Costs Can Usually Be Improved

Reduce unique sizes

Review the window schedule for openings that differ by only a small amount. Where the architecture allows it, using repeatable widths and heights can simplify fabrication, glass ordering, labeling and installation.

This works best before framing begins. It is much harder after rough openings are already built.


Limit glass makeups

A project may need safety glass in selected locations and a different solar-control glass on exposed elevations. That does not mean every room needs its own glass specification.

Ask whether similar openings can share one approved Low-E insulated glass makeup while keeping required U-Factor, SHGC and safety performance.


Use fixed glass carefully

Fixed windows use less hardware and usually require less fabrication than operable windows. In large combination units, a fixed center panel with smaller operable sections may provide the needed view and ventilation at a better cost.

Only make this change where ventilation, cleaning access and egress are not affected.


Standardize finishes

One project-wide frame color is easier to purchase and control than several similar custom finishes. Small batches of special powder-coat colors may add setup time, minimum quantities and color-matching work.

Keep the coating specification suitable for the project environment, especially for coastal or high-UV locations.


Simplify hardware

Standard handles, locks, screen types and hardware colors make ordering and future replacement easier. Oversized sashes and heavy doors may still need upgraded hinges, rollers or multipoint locks.

The goal is fewer unnecessary options, not lower-capacity hardware.


Plan delivery sooner

Packaging by building, floor or unit can reduce site handling and lost installation time. Builders should decide early whether the project needs one shipment or phased delivery.

A lower factory price can disappear quickly if windows arrive in the wrong sequence or need to be moved several times on site.


Safe Value Engineering vs Risky Cost Cutting

Scope Item Safer VE Move What Not to Do
Window Sizes Combine similar dimensions after reviewing plans and rough openings Force one size into openings that require different clearances or egress
Glass Reduce the number of approved glass makeups Remove required Low-E, tempered or laminated glass
Operation Use fixed panels where ventilation and access are not required Remove required operable or emergency escape windows
Frame System Match the aluminum system to the actual size and exposure Select a lighter system without checking design pressure and tested size
Finish Use one standard project color where possible Choose a coating that is unsuitable for coastal or severe exposure
Hardware Standardize handles, locks and screen options Use undersized hardware on large or heavy operable panels
Delivery Pack and label by the installation sequence Reduce packaging protection just to lower freight volume

What Value Engineering Looks Like on a Real Window Schedule

Hypothetical 96-unit apartment project

The building performance stays the same. The package becomes easier to produce.

Original window package
  • 14 different window sizes
  • 4 insulated glass makeups
  • 3 hardware finishes
  • Operable sashes in several locations that did not require ventilation
  • Packaging not assigned by floor
Revised package for pricing
  • 8 repeatable window sizes
  • 2 approved glass makeups
  • 1 standard hardware finish
  • Fixed panels used only where operation was not required
  • Packages labeled by building and floor

The U-Factor, SHGC, design pressure, safety glass and installation details remain unchanged. The supplier now has fewer custom variables to purchase, fabricate, inspect and pack.

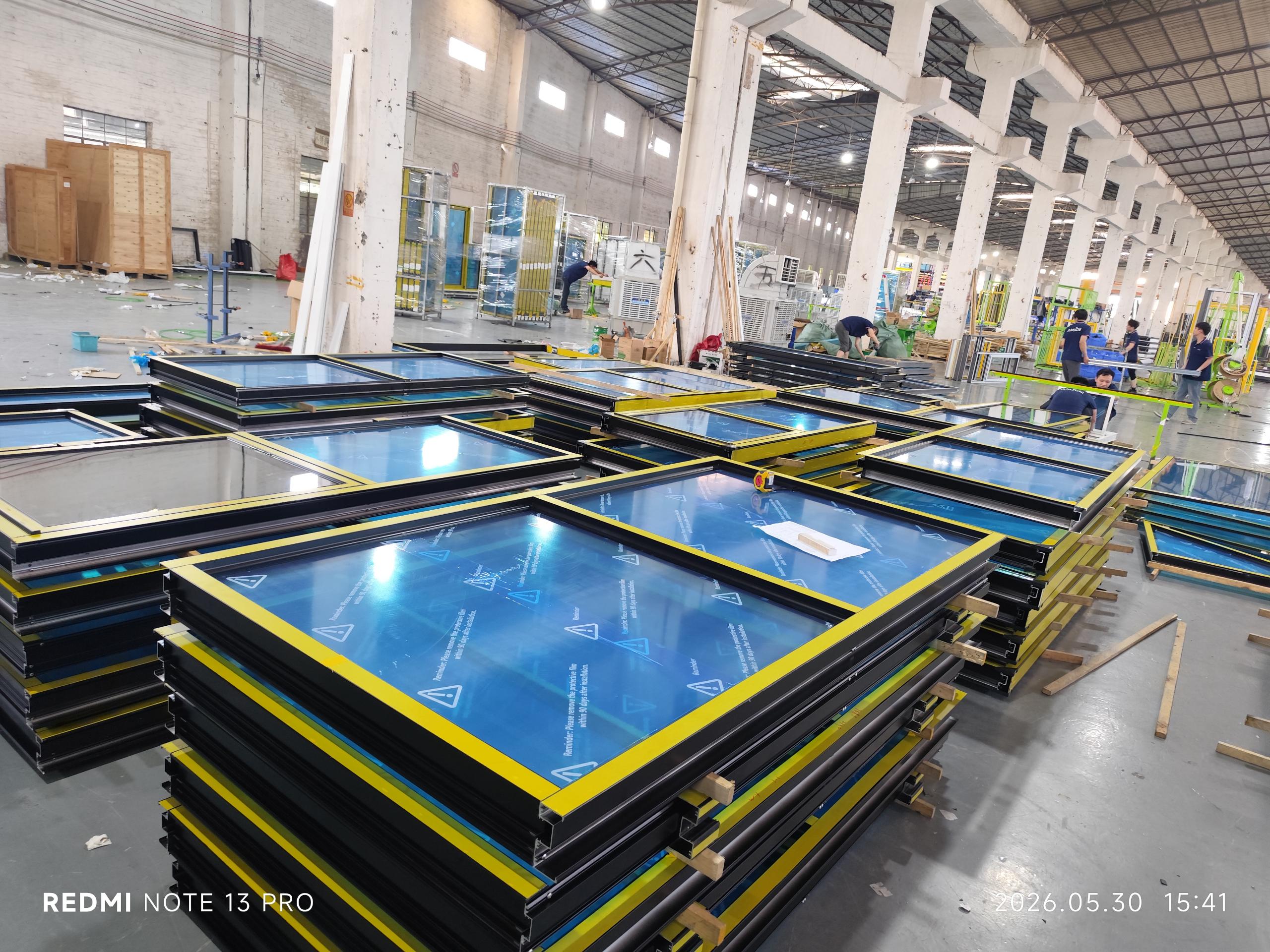

Factory quality inspection for custom aluminum windows

What Builders Should Ask Suppliers to Price

Do not ask only for a lower total. Give the aluminum window supplier specific alternatives to price against the same performance criteria.

  • Base quotation matching the current window schedule
  • Alternate price using standardized window sizes
  • Alternate price with fewer glass makeups
  • Fixed-panel alternatives where operation is not required
  • Standard finish compared with a custom color
  • Standard hardware package compared with upgraded options
  • One shipment compared with phased delivery
  • Separate freight, packaging and optional-item pricing

Ask the supplier to list every assumption. A value engineering option is only useful when the builder can see exactly what changed and confirm that the revised product still meets the project requirements.

Frequently Asked Questions

What is the best way to reduce aluminum window cost?

Start by reducing variation in sizes, glass, finishes, hardware and delivery—not by reducing required performance. Repetition usually gives the manufacturer a cleaner package to price.

Are fixed windows less expensive than casement windows?

Fixed windows are generally simpler because they do not need hinges, operators, locks or screens. They are only a valid substitute where ventilation, egress and cleaning access are not required.

Can builders reduce the aluminum profile thickness?

Profile thickness should not be changed on its own. The complete system must still support the required window size, glass weight, hardware and design pressure.

Should every opening use the same glass?

Not always. Safety locations, energy targets and solar exposure may require different glass. The practical goal is to use as few approved glass makeups as the project allows.

When should aluminum windows be value engineered?

Review the package after the main performance requirements and openings are defined, but before final shop drawings, framing and production release.

What should builders send for a value engineering review?

Send the window schedule, architectural drawings, rough opening sizes, glass requirements, U-Factor, SHGC, design pressures, finish, hardware, screens and delivery plan.


AMJ Aluminum Window Value Engineering Support

AMJ works with builders, contractors, developers and distributors on custom aluminum window and door packages. Our team can review the window schedule, BOQ, drawings, glass, hardware and installation options before preparing alternate pricing.

Project buyers can compare custom aluminum window systems and review the window and door project process before sending the current project documents.

Need to Review the Cost of a Window Package?

Send your drawings, window schedule or BOQ. AMJ can identify practical alternatives and show clearly what changes between the base quotation and each value engineering option.

Request a Project Review →

PREVIOUS:How to Choose Aluminum Windows for Townhouse Developments

NEXT:U-Factor, SHGC and Design Pressure: A Practical Guide for Builders
